Measure 36-236

Sheridan School District Bond

The $6 million school bond measure has passed!

2025 Sheridan Schools Bond Updates

Bond Oversight Committee

The BOC consists of community members, staff and two members of the Sheridan School Board. They receive updates on budget, construction and communications for Bond/OSCIM projects from the Project Manager and District staff, make recommendations to the Superintendent and ensure funds are spent as promised.

Project Timelines

Planning and Permitting for Bond projects began in Fall of 2025 while the majority of design work (architects and engineers working closely with the District and Project Managers to develop specific plans) will take place over Fall 2026.

The majority of construction will take place during Summer 2027.

Construction Updates

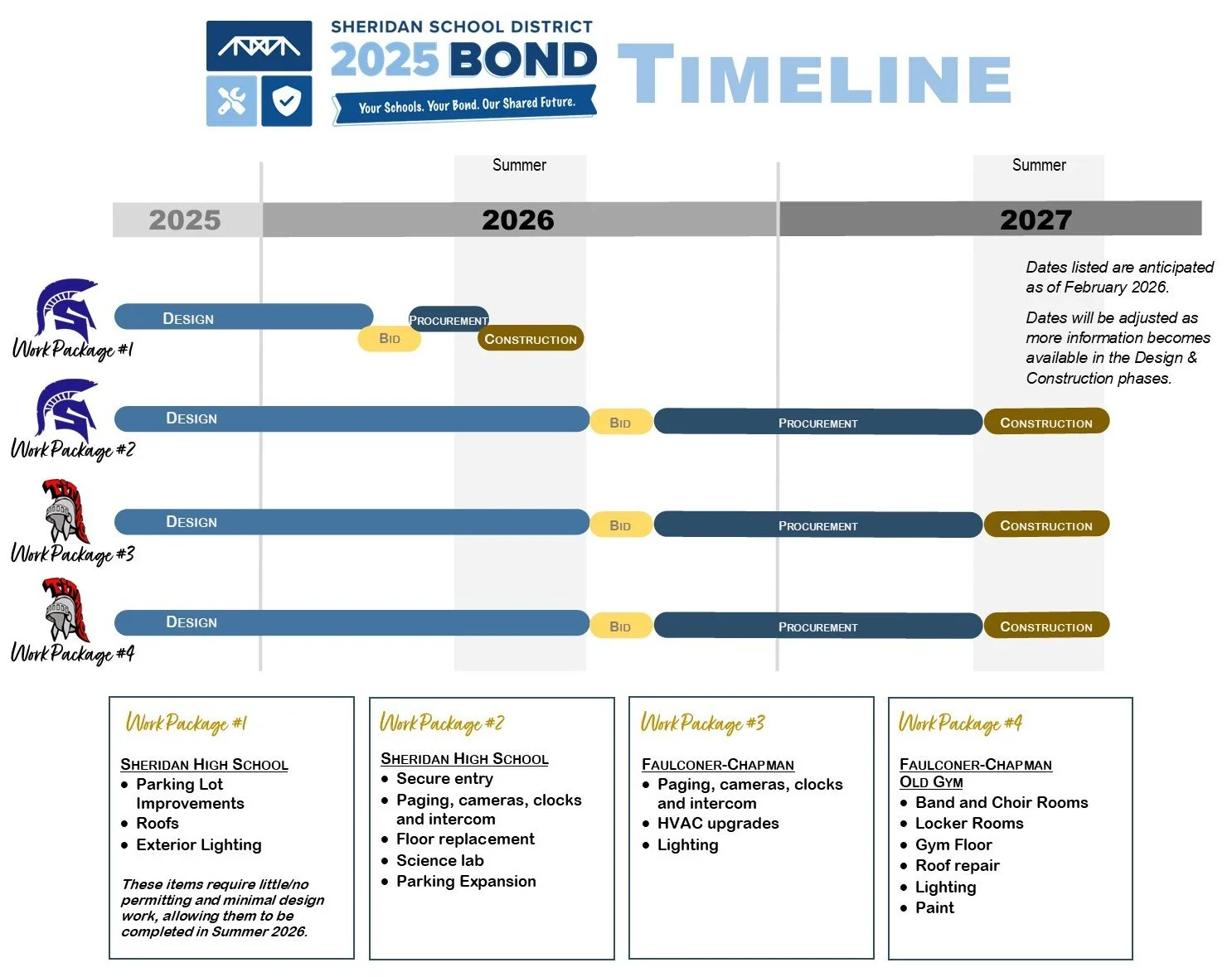

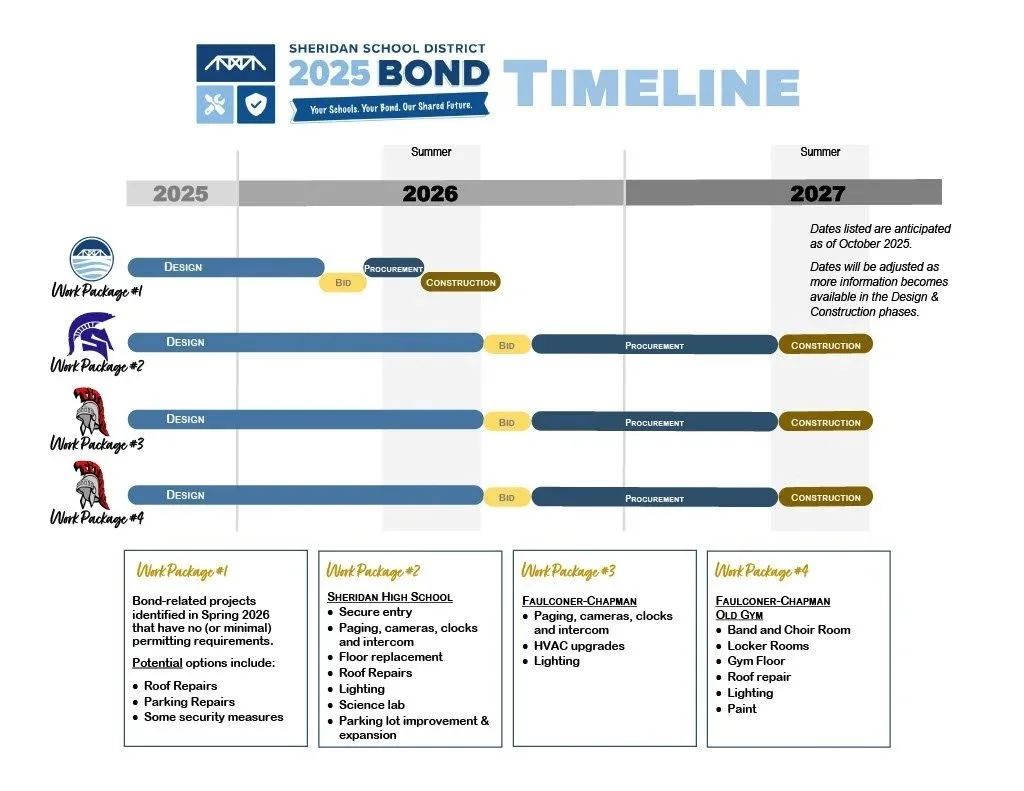

Projects associated with the 2025 Bond have been broken into four separate work packages (see Timeline graphic).

Work Package #1 was completed in Summer 2026, while #2, 3 & 4 will focus on more complex projects in Summer 2027. See updates below for more information.

Bond Updates & Progress

2025 Sheridan Schools Bond Projects (by School)

Projects at Sheridan High School:

Projects at Faulconer-Chapman:
